Project Development Lifecycle of Solar Power Plant

In this chapter, we will learn about the complete project development lifecycle of solar power plant. Here, we will understand various stages of project development of solar power plants starting from site identification to commissioning with practical examples.

Complete project development lifecycle of a utility-scale solar power plant from site identification, feasibility study, engineering design, construction, commissioning to operation and maintenance

What is Project Development Lifecycle?

In the context of solar power plants, Project Development Lifecycle can be defined as a systematic process of converting a solar power plant idea into a completely operational power generating station.

Each stage of project development lifecycle has specific objectives, documents, approvals, and technical activities. If we miss or delay any stage, then it can increase project cost, delay commissioning, or even cause project failure.

Importance of Project Development Lifecycle

A structured project development process offers several advantages and helps in –

  • Reducing project risks
  • Improving project quality
  • Controlling project cost
  • Completing the project on schedule
  • Ensuring regulatory compliance
  • Improving plant performance
  • Increasing project profitability
  • Achieving long-term reliability

Typical Project Development Lifecycle of Solar Power Plant

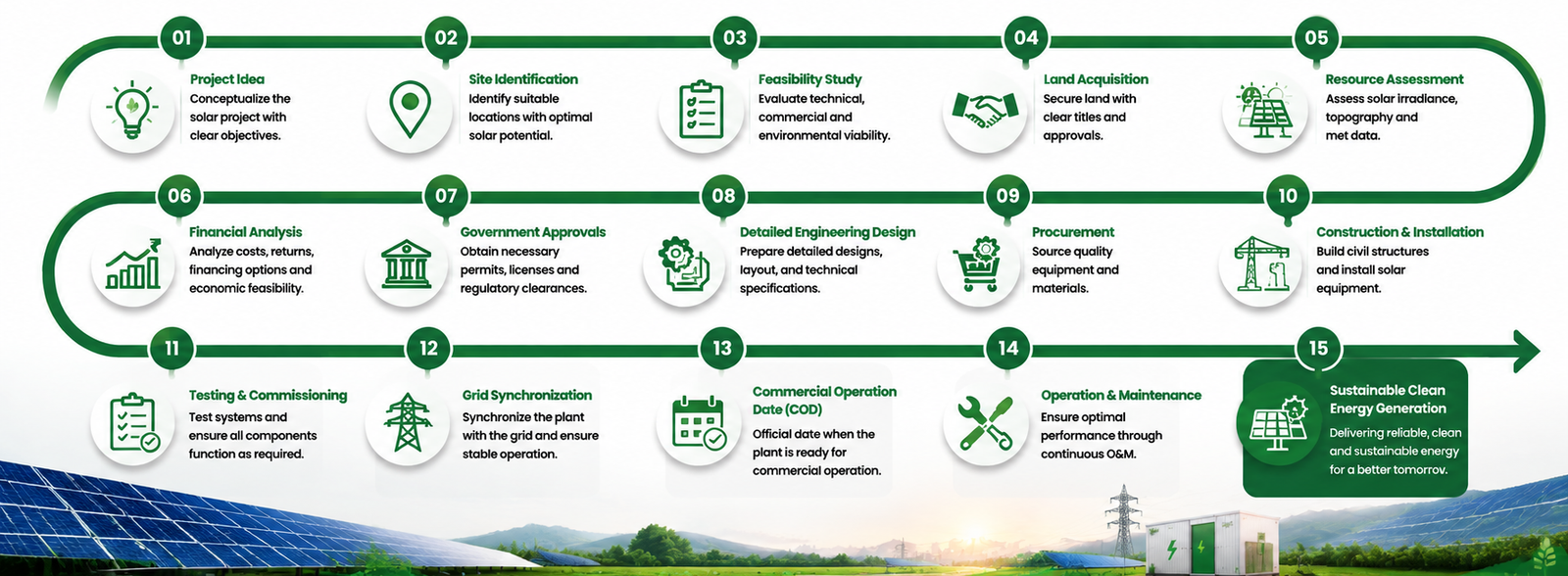

The following figure depicts the typical project development lifecycle of a utility-scale solar power plant –

Stages of solar power plant project development lifecycle showing site identification, feasibility study, engineering design, procurement, construction, commissioning, grid synchronization and operation & maintenance

Let’s understand each stage of the project development lifecycle of the solar power plant in detail.

Stage 1: Project Identification

Every solar project starts with finding the opportunity. During this stage, the power plant developer makes the following major decisions –

  • Plant capacity (5 MW, 50 MW, 100 MW, 500 MW, etc.)
  • Project location
  • Type of project
  • Target customers
  • Investment model
  • Expected revenue

For example, a solar developer decides to install a 100 MW Solar PV Plant in Rajasthan because he identified the following –

  • High solar irradiation
  • Availability of land
  • Strong transmission network
  • Government incentives

Stage 2: Site Identification

At this stage, the developer will select the right site. This stage plays an important role because a poor site can reduce energy generation for the next 25 years.

The major factors considered for right site selection will be –

  • Solar irradiation
  • Flat terrain
  • Soil condition
  • Flood history
  • Water availability
  • Accessibility
  • Distance from transmission line
  • Environmental impact
  • Land ownership
  • Shadow-free area

Important Note: Never select land only because it is cheap. Poor accessibility, rocky terrain, or weak soil can increase construction costs significantly.

Stage 3: Feasibility Study

Once the site is identified, engineers perform a detailed feasibility study. This study determines whether the project is technically and financially viable.

Part I: Technical Feasibility

Technical feasibility study focuses on –

  • Solar resource assessment
  • Topographical survey
  • Soil investigation
  • Geotechnical analysis
  • Drainage study
  • Wind speed analysis
  • Grid availability
  • Accessibility

Part II: Financial Feasibility

Financial feasibility study is performed to determine –

  • Capital cost (CAPEX)
  • Operating cost (OPEX)
  • Revenue estimation
  • Internal Rate of Return (IRR)
  • Net Present Value (NPV)
  • Payback period
  • Levelized Cost of Energy (LCOE)

Stage 4: Land Acquisition

After confirming the project’s feasibility, land is acquired. The land acquisition process involves the following key activities –

  • Ownership verification
  • Legal due diligence
  • Boundary survey
  • Land registration
  • Mutation
  • Lease agreement (if applicable)

However, the following major challenges are faced in land acquisition –

  • Ownership disputes
  • Agricultural land conversion
  • Forest clearance
  • Local community issues

Stage 5: Solar Resource Assessment

The expected energy generation depends on solar radiation. Therefore, engineering studies must be performed to analyze the following –

  • GHI (Global Horizontal Irradiance)
  • DNI (Direct Normal Irradiance)
  • GTI (Global Tilted Irradiance)
  • Ambient temperature
  • Wind speed
  • Rainfall
  • Historical weather data

For this, engineers generally use the following tools and software –

  • PVsyst
  • Solargis
  • SolarGIS
  • Meteonorm

Stage 6: Grid Connectivity Study

The generated electricity must be injected into the power grid. Therefore, the solar developers must perform the following grid connectivity studies –

  • Nearby substation
  • Voltage level
  • Transmission capacity
  • Short circuit level
  • Grid stability
  • Evacuation route

Stage 7: Government Approvals

Before starting the construction of solar project, several approvals from associated government are required. These may include the following –

  • Land conversion approval
  • Environmental clearance
  • Grid connectivity approval
  • CEIG (Chief Electrical Inspector to Government) approval
  • Electrical Inspector approval
  • Transmission approval
  • Pollution clearance (where applicable)
  • Local authority permissions

Stage 8: Detailed Engineering Design

At this stage, the concept is converted into engineering drawings. Solar design engineers prepare the following key engineering designs and drawings –

  • Plant layout
  • Module layout
  • String layout
  • Inverter sizing
  • Cable sizing
  • Earthing layout
  • Lightning protection
  • SCB layout
  • HT layout
  • Switchyard design
  • Protection philosophy
  • Single Line Diagram (SLD)
  • General Arrangement (GA) drawings

For this, multiple tools and software are used, some of very commonly used are listed below –

  • AutoCAD
  • PVsyst
  • ETAP
  • Helioscope
  • SketchUp
  • STAAD Pro
  • Civil 3D

Stage 9: Procurement

Major equipment used in a solar power plant including solar modules, inverters, string combiner boxes, transformers, HT switchgear, cables, SCADA system and weather monitoring station

Procurement involves purchasing all equipment. The following are major equipment related to solar power plant –

Equipment

Function

Solar Modules Generate DC electricity
Solar Inverters Convert DC to AC
Module Mounting Structure Holds & Supports modules
SCB (String Combiner Box) Combines string outputs
LT Panels AC distribution
Transformers (IDT & PTR) Voltage step-up
HT Switchgear Grid connection & protection
Cables Power transmission
Earthing Material Safety
Lightning Protection System Protects against lightning & surges
SCADA Real-time plant monitoring
Weather Station Environmental monitoring

Stage 10: Project Construction & Installation

This is the execution phase where the plant is physically developed. The major activities performed during this stage include –

  • Land clearing
  • Boundary fencing
  • Road construction
  • Foundation work
  • Module mounting structure installation
  • Module installation
  • Cable laying
  • Earthing installation
  • Inverter installation
  • Transformer installation
  • Switchyard construction
  • SCADA installation

During erection of project, the following safety practices must be followed by the construction teams –

  • PPE (Personal Protective Equipment) usage
  • Lockout-Tagout (LOTO)
  • Work at height procedures
  • Electrical safety
  • Crane safety
  • Excavation safety
  • Permit to Work (PTW)

Stage 11: Testing & Commissioning

Before final energization of the system, every part of the system must be tested to avoid any kind of failure. In solar power plant, the following common tests are performed during testing & commissioning –

  • Insulation Resistance Test
  • Continuity Test
  • Polarity Test
  • Earth Resistance Test
  • Transformer Tests
  • Relay Testing
  • Protection Testing
  • Inverter Functional Test
  • String Testing
  • IV Curve Test
  • Thermography
  • SCADA Communication Test

Stage 12: Grid Synchronization

After completing the testing phase, the plant is synchronized with the power grid. At this stage, the following parameters are verified as per grid compliance –

  • Voltage
  • Frequency
  • Phase sequence
  • Protection settings
  • Synchronization conditions

Only after approval is power exported to the grid.

Stage 13: Commercial Operation Date (COD)

COD is the official date from which the solar plant starts commercial electricity generation under the Power Purchase Agreement (PPA). From this date –

  • Revenue generation begins.
  • Energy billing starts.
  • Performance guarantees become applicable.
  • O&M responsibilities commence.

Stage 14: Operation & Maintenance (O&M)

In general, the solar project lifecycle continues for 25 years or more through efficient operation and maintenance. In a solar power plant, the following daily O&M activities are performed by engineers –

  • SCADA monitoring
  • Radiation & Generation analysis
  • Module cleaning
  • Vegetation control
  • Preventive maintenance
  • Breakdown maintenance
  • Inverter inspection
  • Transformer maintenance
  • Thermography
  • PR and CUF analysis

Documents Generated During the Solar Project Development

At different stages of project development of a solar power plant, the following major documents are generated & kept for future references –

Project Development Stage

Document Generated

Feasibility Feasibility Report, DPR (Daily Progress Report)
Survey Topographical Survey Report
Soil Investigation Geotechnical Report
Design SLD (Single Line Diagram), GA (General Arrangement), Layout Drawings
Procurement BOQ (Bill of Quantity), Technical Specifications, Purchase Orders
Construction Method Statements, Inspection Reports
Testing FAT (Factory Acceptance Test), SAT (Site Acceptance Test), Test Reports
Commissioning Commissioning Report
Handover As-built Drawings, O&M Manual, Warranty Documents

Roles of Different Engineers

In a solar power plant project, different engineers are appointed to perform different types of duties –

Engineer Roles

Responsibilities

Solar Design Engineer Plant design, layouts, simulations
Electrical Design Engineer SLD, protection, cable sizing
Civil Engineer Foundations, roads, drainage
Procurement Engineer Equipment sourcing
Project Engineer Coordination and execution
Site Engineer Daily construction supervision
QA/QC Engineer Quality inspections
Commissioning Engineer Testing and energization
SCADA Engineer Monitoring system integration
O&M Engineer Long-term plant performance monitoring

Practical Challenges in Indian Solar Projects

Engineers face the following major challenges in Indian solar plant projects –

  • Delays in land acquisition
  • Monsoon affecting construction
  • Supply chain disruptions
  • Module delivery delays
  • Transformer shortages
  • Grid connectivity delays
  • Right-of-way (ROW) issues
  • Labor shortages
  • Wildlife and environmental restrictions
  • Unexpected soil conditions
  • Grid curtailments after commissioning

Best Practices for Successful Solar Project Development

Solar developers could follow the below mentioned best practices to make their solar project development successful –

  • Conduct detailed site surveys before land purchase.
  • Use reliable solar resource data for energy estimation.
  • Complete all statutory approvals before starting construction.
  • Standardize engineering drawings and technical specifications.
  • Procure equipment from reputed manufacturers.
  • Implement strict quality control during installation.
  • Maintain clear communication among developers, EPC contractors, utilities, and vendors.
  • Perform comprehensive pre-commissioning tests.
  • Maintain complete documentation for future O&M and audits.
